George Street Watermain Rehabilitation and Site Servicing

Share George Street Watermain Rehabilitation and Site Servicing on Facebook Share George Street Watermain Rehabilitation and Site Servicing on X (formerly Twitter) Share George Street Watermain Rehabilitation and Site Servicing on Linkedin Email George Street Watermain Rehabilitation and Site Servicing link

Welcome! Thank you for visiting the George Street Servicing and Road Improvements project page. Here you’ll find information about the project, construction updates, and what to expect as work progresses.



What are we doing?

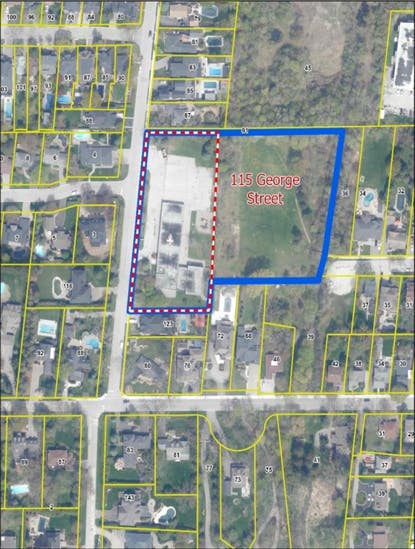

The Town of Aurora is undertaking infrastructure improvements on George Street.

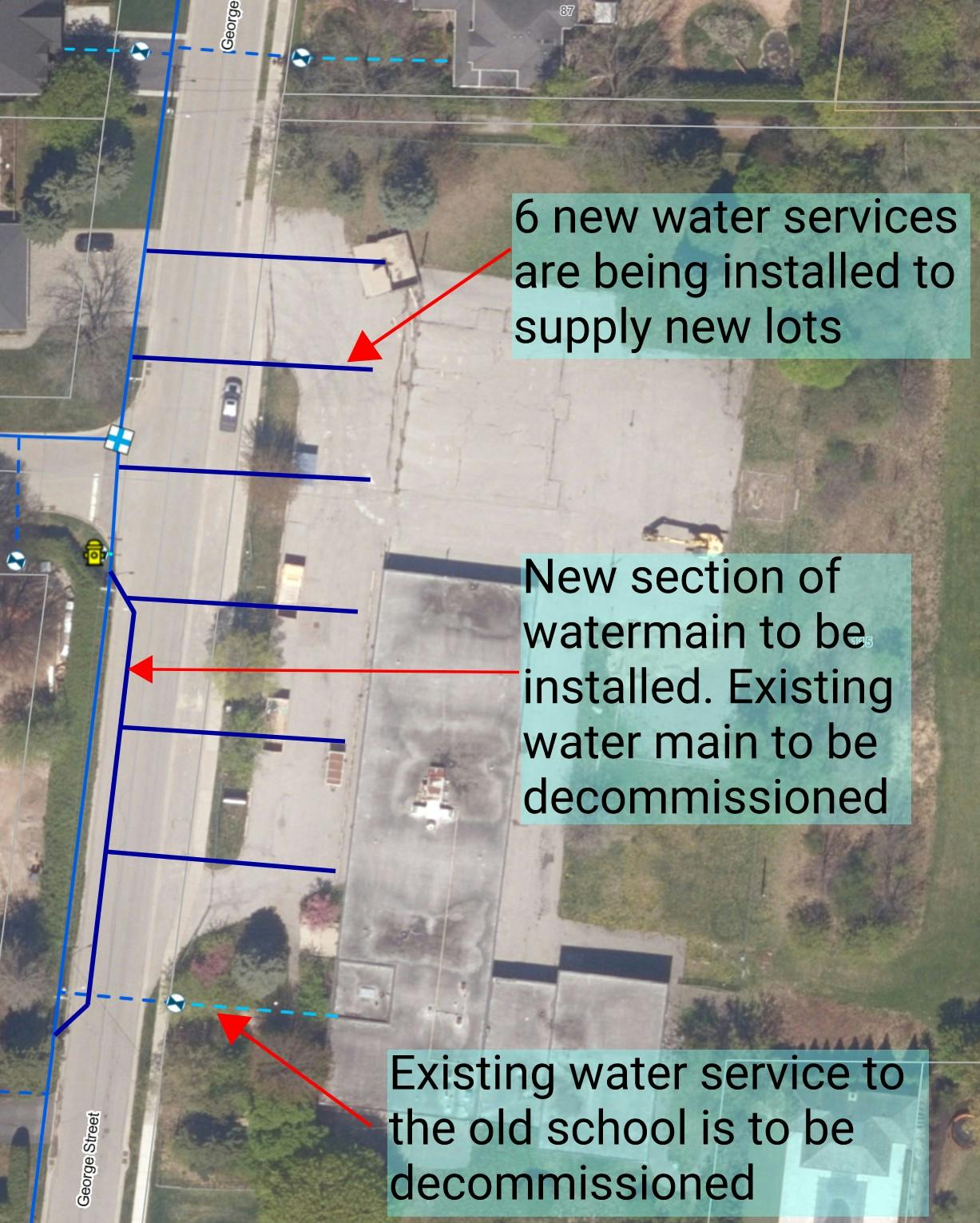

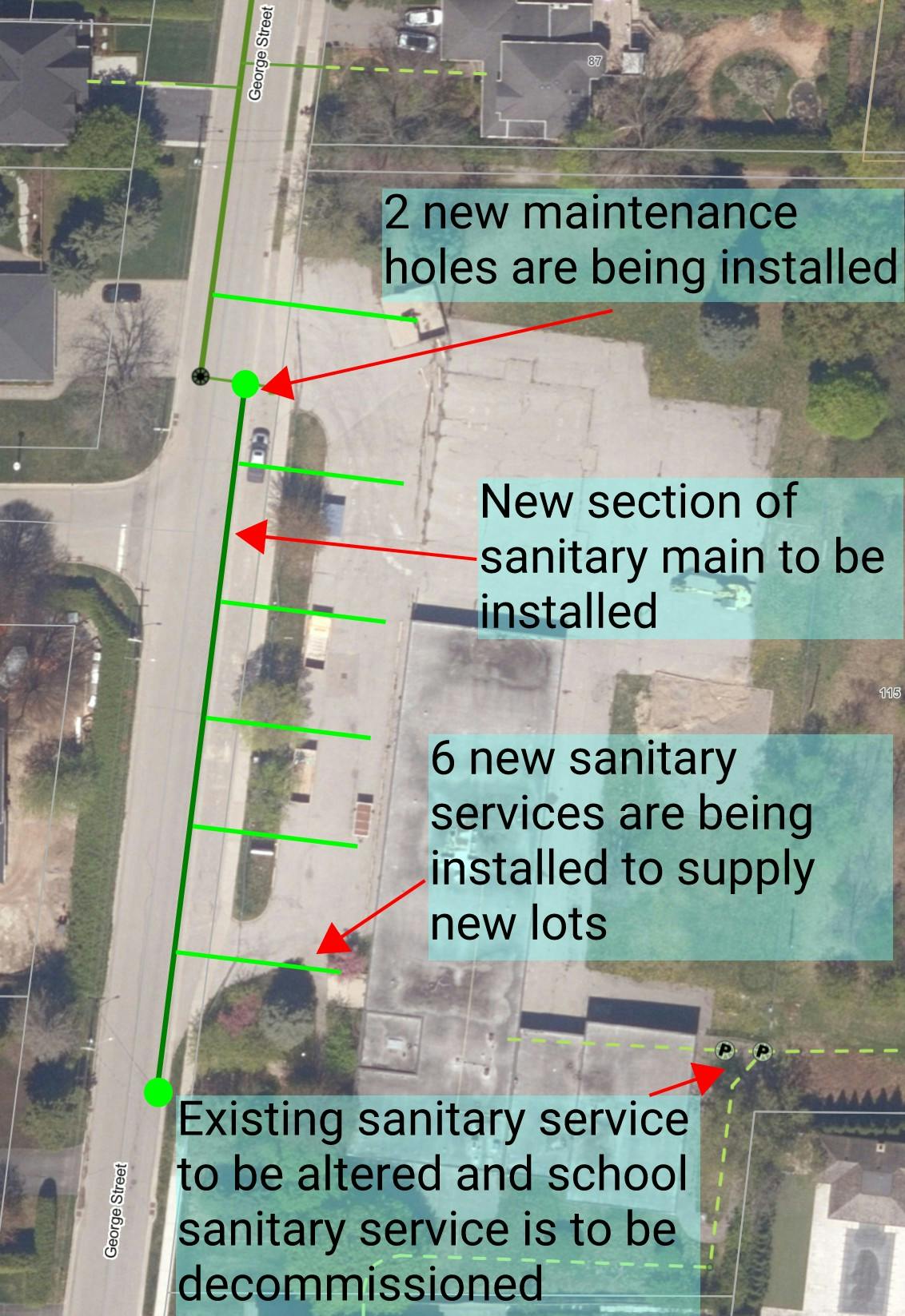

• Installing new water and sanitary service connections.
• Improving stormwater drainage.
• Replacing and realigning the sidewalk and curb on the east side of George Street.
• The road will be rehabilitated during the final stage of construction.

Construction is expected to take place from September to December 2026.

What to expect during construction:

  • Increased construction traffic
  • Lane reduction during working hours
  • Increased noise during working hours
  • Increased dust generation (dust control measures are enforced)
  • Construction fencing to protect the public from open excavations

Welcome! Thank you for visiting the George Street Servicing and Road Improvements project page. Here you’ll find information about the project, construction updates, and what to expect as work progresses.



What are we doing?

The Town of Aurora is undertaking infrastructure improvements on George Street.
• Installing new water and sanitary service connections.
• Improving stormwater drainage.
• Replacing and realigning the sidewalk and curb on the east side of George Street.
• The road will be rehabilitated during the final stage of construction.

Construction is expected to take place from September to December 2026.

What to expect during construction:

  • Increased construction traffic
  • Lane reduction during working hours
  • Increased noise during working hours
  • Increased dust generation (dust control measures are enforced)
  • Construction fencing to protect the public from open excavations
  • Project Update- October 5 to 9, 2026

    Share Project Update- October 5 to 9, 2026 on Facebook Share Project Update- October 5 to 9, 2026 on X (formerly Twitter) Share Project Update- October 5 to 9, 2026 on Linkedin Email Project Update- October 5 to 9, 2026 link

    Hello everyone,

    The contractor will install the watermain on Monday and begin the watermain testing procedure on Tuesday. They will also begin installing the sanitary main on George Street on Tuesday and continue the work until Friday.

    Further updates will be provided as work progresses.

    Thank you for your patience.

    Hello everyone,

    The contractor will install the watermain on Monday and begin the watermain testing procedure on Tuesday. They will also begin installing the sanitary main on George Street on Tuesday and continue the work until Friday.

    Further updates will be provided as work progresses.

    Thank you for your patience.

  • Project Update - October 3, 2026

    Share Project Update - October 3, 2026 on Facebook Share Project Update - October 3, 2026 on X (formerly Twitter) Share Project Update - October 3, 2026 on Linkedin Email Project Update - October 3, 2026 link

    Hello,

    Please be advised that the contractor will be onsite for a few hours on Saturday (Oct 3rd), to complete the temporary asphalt patch work.

    Further updates will be provided as work progresses.

    Have a nice weekend!

    Thank you

    Hello,

    Please be advised that the contractor will be onsite for a few hours on Saturday (Oct 3rd), to complete the temporary asphalt patch work.

    Further updates will be provided as work progresses.

    Have a nice weekend!

    Thank you

  • Project Update - September 29 to October 2, 2026

    Share Project Update - September 29 to October 2, 2026 on Facebook Share Project Update - September 29 to October 2, 2026 on X (formerly Twitter) Share Project Update - September 29 to October 2, 2026 on Linkedin Email Project Update - September 29 to October 2, 2026 link

    Hello,

    The contractor’s surveyor will be onsite Wednesday for the layout. Asphalt saw cutting is scheduled for Thursday, and road excavation for the watermain installation will begin on Friday.

    Further updates will be provided as work progresses.

    Thank you

    Hello,

    The contractor’s surveyor will be onsite Wednesday for the layout. Asphalt saw cutting is scheduled for Thursday, and road excavation for the watermain installation will begin on Friday.

    Further updates will be provided as work progresses.

    Thank you

  • Project Update - September 28, 2026

    Share Project Update - September 28, 2026 on Facebook Share Project Update - September 28, 2026 on X (formerly Twitter) Share Project Update - September 28, 2026 on Linkedin Email Project Update - September 28, 2026 link

    Hello all,

    Select trees were removed this morning. All six (6) of the trees were chipped and removed from the site.

    Additional materials are scheduled to be delivered within the next two days. Road saw cuts are to begin on Wednesday to aid in the removal of asphalt coming next week.

    Stay tuned for further updates.

    Thank you.

    Hello all,

    Select trees were removed this morning. All six (6) of the trees were chipped and removed from the site.

    Additional materials are scheduled to be delivered within the next two days. Road saw cuts are to begin on Wednesday to aid in the removal of asphalt coming next week.

    Stay tuned for further updates.

    Thank you.

  • Project Update - September 21, 2026

    Share Project Update - September 21, 2026 on Facebook Share Project Update - September 21, 2026 on X (formerly Twitter) Share Project Update - September 21, 2026 on Linkedin Email Project Update - September 21, 2026 link

    Hello,

    The contractor is scheduled to commence work during the week of September 28, including mobilization, tree removals, and material deliveries. The surveyor will be onsite on September 24 for the layout work.

    Further updates will be provided as work progresses.

    Thank you

    Hello,

    The contractor is scheduled to commence work during the week of September 28, including mobilization, tree removals, and material deliveries. The surveyor will be onsite on September 24 for the layout work.

    Further updates will be provided as work progresses.

    Thank you

  • Project Update - September 18, 2026

    Share Project Update - September 18, 2026 on Facebook Share Project Update - September 18, 2026 on X (formerly Twitter) Share Project Update - September 18, 2026 on Linkedin Email Project Update - September 18, 2026 link

    Contractors will be commencing mobilization activities in preparation for the upcoming servicing works.

    Starting Monday September 21, traffic control devices, including pylons, delineators, and signage, will be delivered and installed on site ahead of upcoming traffic disruptions. As a result, George Street and Hawthorne Lane may experience increased congestion during working hours.

    We ask for your patience and understanding while the contractor sets up and relocates equipment throughout the work area.

    As construction activities increase, more regular project updates will be provided in the coming weeks as road construction gets underway.

    Thank you for your cooperation.

    Contractors will be commencing mobilization activities in preparation for the upcoming servicing works.

    Starting Monday September 21, traffic control devices, including pylons, delineators, and signage, will be delivered and installed on site ahead of upcoming traffic disruptions. As a result, George Street and Hawthorne Lane may experience increased congestion during working hours.

    We ask for your patience and understanding while the contractor sets up and relocates equipment throughout the work area.

    As construction activities increase, more regular project updates will be provided in the coming weeks as road construction gets underway.

    Thank you for your cooperation.

  • Project Update - September 10, 2026

    Share Project Update - September 10, 2026 on Facebook Share Project Update - September 10, 2026 on X (formerly Twitter) Share Project Update - September 10, 2026 on Linkedin Email Project Update - September 10, 2026 link

    Hello,

    We are excited to welcome Rabcon Contractors Ltd. as our project partner and the successful contractor responsible for carrying out the construction works. A pre-construction meeting was held earlier this week to discuss project timelines. The expected construction start date is September 24, 2026.

    Coordination with the various utility companies to decommission the utility poles on the property is underway. Underground infrastructure locates have also been completed to ensure safe and efficient trenching activities.

    Tree protection measures and the removal of select trees are expected to begin within the next two weeks.

    Thank you.

    Hello,

    We are excited to welcome Rabcon Contractors Ltd. as our project partner and the successful contractor responsible for carrying out the construction works. A pre-construction meeting was held earlier this week to discuss project timelines. The expected construction start date is September 24, 2026.

    Coordination with the various utility companies to decommission the utility poles on the property is underway. Underground infrastructure locates have also been completed to ensure safe and efficient trenching activities.

    Tree protection measures and the removal of select trees are expected to begin within the next two weeks.

    Thank you.

  • Project Update - August 27, 2026

    Share Project Update - August 27, 2026 on Facebook Share Project Update - August 27, 2026 on X (formerly Twitter) Share Project Update - August 27, 2026 on Linkedin Email Project Update - August 27, 2026 link

    Hello,

    The Town’s geotechnical consultant will be on site on Monday (August 31st) to conduct soil sampling. Please note that some drilling-related noise can be expected during this work.

    Further updates will be provided as work progresses.

    Thank you!

    Hello,

    The Town’s geotechnical consultant will be on site on Monday (August 31st) to conduct soil sampling. Please note that some drilling-related noise can be expected during this work.

    Further updates will be provided as work progresses.

    Thank you!

Page last updated: 05 Oct 2026, 12:08 PM
